Edge coloring as scheduling 2026-10-14
Suppose each job occupies two distinct resources for one whole slot, and each resource can serve at most one job in that slot. Make resources vertices and jobs edges. Two jobs conflict exactly when their edges share a vertex, so a valid schedule is a proper edge colouring. Each slot is a matching in a graph; the chromatic index is the minimum number of slots. The colour labels specify the slots, rather than physical colours. This model assumes all jobs are available initially, with equal duration, interchangeable slots and no additional conflicts. The school-timetable motivation in Graph Theory by Reinhard Diestel (author-hosted Colouring preview, opening paragraphs, pp. 123–124) uses this resource-pair interpretation.
Here is a complete example. Two technicians must each use three instruments once. Each job needs its technician and its instrument simultaneously. The six jobs are the edges of the complete bipartite graph :Within each , the two jobs use different technicians and different instruments, so is a matching in a graph. The three matchings in a graph together cover every job exactly once. Technician has three jobs, so fewer than three slots cannot suffice; the displayed schedule uses three. This is an optimal proper edge colouring with chromatic index three, witnessed by both a schedule and a resource-workload lower bound.
Repeated jobs requiring the same resource pair become distinct parallel edges of a multigraph, rather than one edge. Additional restrictions change the problem: prescribed allowed slots lead to list edge coloring, while unequal durations, deadlines, or jobs needing more than two resources require a richer scheduling model. Selecting a largest matching in a graph solves a single-round question; a shortest complete schedule must organize all jobs across rounds.
Hall allocation model 2026-10-14
In a unit-capacity assignment problem, left vertices represent demands and right vertices represent individually usable resources; an edge records compatibility. All constraints must be encoded by those allowed pairs and by using each resource at most once. Hall's marriage theorem decides feasibility. Costs belong to an additional mathematical optimization problem; precedence between jobs or requirements for consecutive slots need additional modelling.
The authored Notes on the design of a conference scheduler by David R. MacIver (Implementation, 7 August 2022) illustrates a Hall obstruction with four talks confined to three slots. With one talk per slot, that subset has size four and a graph neighbourhood of size three. An unused slot outside its graph neighbourhood does not remove the bottleneck. In the three-job example above, the same scheduling model instead has two complete assignments.
The allocation exercise in Graph Theory by Reinhard Diestel (Matching, Covering and Packing, printed p. 20, Exercise 9) asks for disjoint subsets of prescribed nonnegative integer sizes . Replace demand by left vertices with allowed resource set . Hall's marriage theorem gives exactly the conditionFor a numerical instance, let , , and . The separate demands and their combined demand fit, and works. Raising to two leaves both individual tests valid but demands four distinct resources from a set union of size three. This is the same collective obstruction with repeated demand vertices.
Hall's marriage theorem Created 2026-10-14 Updated 2026-10-14
For a finite bipartite graph with disjoint left and right vertex sets, Hall's marriage theorem characterizes when distinct allowed partners can be chosen for every left vertex. A matching in a graph with matching saturation of exists if and only if every subset satisfiesThe graph neighbourhood counts distinct right vertices, rather than edges or repeated choices. This is the Hall condition. Its failure supplies a concrete Hall obstruction. Necessity follows because the chosen partners of are distinct members of ; sufficiency is the surprising assertion that these collective counts rule out every obstacle.[ref]
The right side may be larger: matching saturation of leaves right vertices unmatched. Only when does a matching in a graph saturating automatically become a perfect matching. For a specified subset , apply the same criterion only to , using the induced subgraph on . The remaining left vertices need not be matched. The empty set gives ; if is empty, the empty matching in a graph suffices.
Consider a scheduling model with three unit-duration jobs and four available slots on one machine. Each job needs exactly one slot, each slot accepts at most one job, and the allowed slots areThe bipartite graph below admits , a matching in a graph saturating all jobs while leaving slot unused. It is not a perfect matching of the seven-vertex graph. A greedy choice initially blocks , but the augmenting path in a matching replaces by ; subsequent assignment of succeeds. A bad partial choice is not an impossibility certificate.
There are eight subsets of . Listing each graph neighbourhood makes the all-subset requirement explicit:
There are exactly two matchings in a graph saturating : and . Job forces slot , then job forces slot , leaving two choices for .
Makespan 2026-10-31
The time at which all work in a scheduling instance has finished, equivalently the largest completion time measured from a common start. For divisible job sizes and positive machine speeds , when each machine's completion time is its total assigned size divided by its speed, the minimum makespan is . The lower bound follows from total processing capacity; assigning the fraction of each job to machine attains it.
Mathematical optimization Created 2026-09-24 Updated 2026-10-13
Mathematical optimization turns a preference into a precise question: among the allowed decisions, which gives the best outcome? A model separates the objective function, which measures quality, from the optimization constraints, which determine the feasible set. This language unifies finding a cheap plan for a transportation problem, efficient scheduling, or an accurate model in linear regression. The separation is useful because changing a preference and changing what is possible are different modeling decisions. See Boyd and Vandenberghe, introductory optimization models.
For an objective function , a maximization problem asks for a feasible point satisfying for every ; a minimization problem reverses the inequality. This is a global extremum. A local maximum or local minimum compares only nearby feasible points, so finding one does not settle the global question.
Consider allocating ten units between two complementary inputs:The budget constraint forces a tradeoff: an extra unit of costs a unit of . The best allocation is , with objective function value . Without the budget constraint, gives : there is no global maximum. Constrained optimization can therefore have a finite answer even when the corresponding problem with fewer optimization constraints does not. Its beauty is that geometry, calculus, and an arithmetic-geometric mean inequality can certify the same answer.
Assume job sizes and machine speeds , with at least one machine. Let be the amount of job assigned to machine , and let be the proposed makespan. Use the linear programThe first family of constraints assigns every job completely. The second bounds each machine's completion time by , since is equivalent to . It is a linear inequality because is an input constant. There is no integrality restriction: jobs are divisible as specified in this scheduling model.
To verify the formulation, any actual allocation defines the variables above, with equal to its largest completion time, and satisfies every constraint. Conversely, from a feasible solution, assign amount to machine and process its assigned pieces consecutively. Its total time is at most , so the linear program realizes the claimed makespan.
Project scheduling 2026-10-13
Project scheduling asks how quickly a collection of dependent activities can finish. Adding their durations usually overestimates the answer, because independent activities can run together; taking only the longest single activity usually underestimates it, because some activities must wait. The critical path method identifies the chain of dependencies that determines the finish time. Its simplest model assumes known, fixed durations, unlimited parallel processing, and precedence requirements saying that each predecessor must finish before its successor starts. These are the assumptions of the basic model in Hendrickson, Project Management for Construction, §10.2.
Represent each activity by a vertex of a finite Directed acyclic graph; an edge means that activity waits for activity . Activity runs without interruption for duration , starting at . The optimization constraints and project finish time areThe objective function is to minimize . All durations and start times use the same time unit, and the project starts at time zero. The Directed acyclic graph assumption allows a topological order in which every predecessor is processed first.

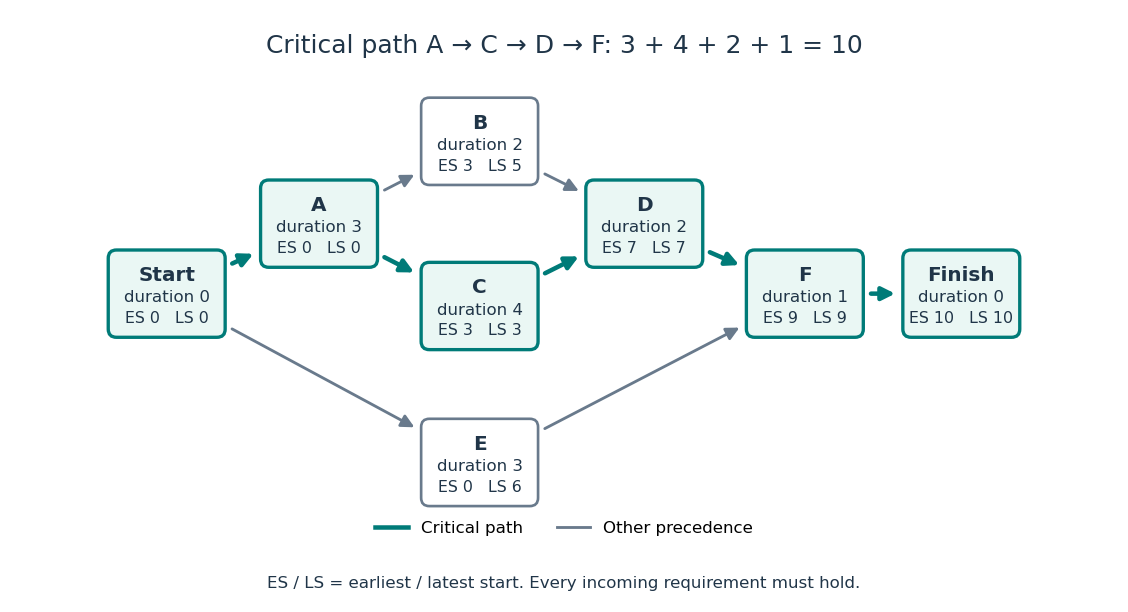

Consider this small, abstract project:
Activities A and E may start together. After A finishes, B and C may run together, but D must wait for both. F must similarly wait for both D and E: a merge means all incoming requirements must hold. This activity-as-vertex convention keeps durations on the activities and uses arrows only to express precedence.
Unlimited parallel processing is essential to the equality between the longest graph path duration and the optimal finish time. For example, two independent chains, each containing two activities of duration 3, have longest graph path duration 6. Two processors can finish both chains in 6, but one processor needs 12 because all four activities must run sequentially. Thus with limited resources the longest graph path still gives a lower bound, but it need not be achievable. Such resource requirements belong to the broader subject of scheduling.
